San Diego College Of Continuing Education Mesa Building Envelope Improvements

Project Schedule

Programming Complete Design and DSA Approval Construction Completion (Est.) FFE and Move-In (Est.)
May 2026 Design: August 2026
DSA Approval: March 2027
August 2028 October 2028

Current Status/Phase: 50% Construction Documents are due 7/10. Geotechnical services and hazardous materials ongoing.

Project Progress Update

Upcoming Milestones:

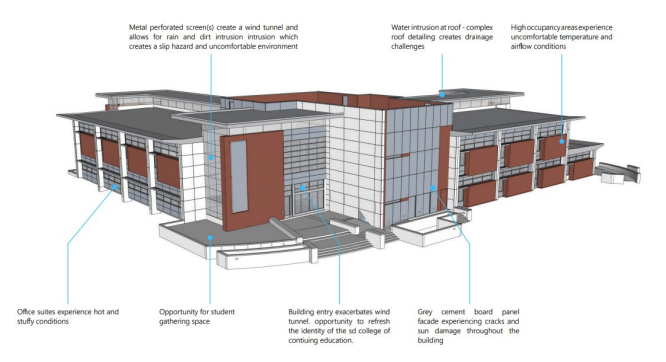

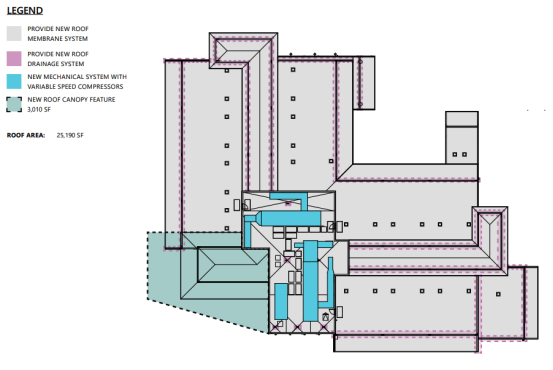

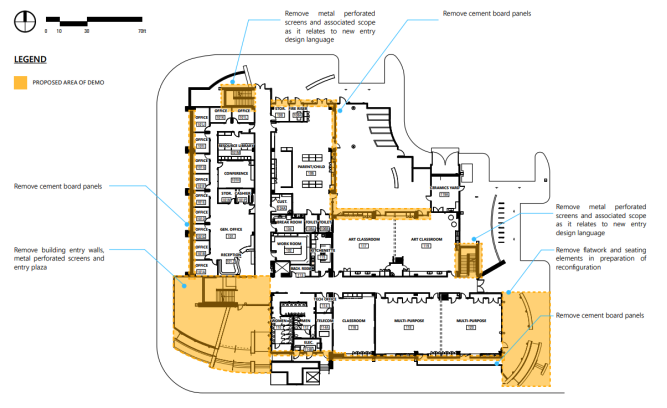

San Diego College of Continuing Education Mesa Building Envelope Improvements #1  San Diego College of Continuing Education Mesa Building Envelope Improvements #2  San Diego College of Continuing Education Mesa Building Envelope Improvements #3

Project Features

The San Diego College of Continuing Education Mesa Building Envelope Improvements project is focused on improvements which contribute to a more welcoming and efficient learning environment while aligning with the campus’s long-term Master Plan. Project improvements include:

CONCEPT-LEVEL PLANS — Subject to revision. Not a final design.

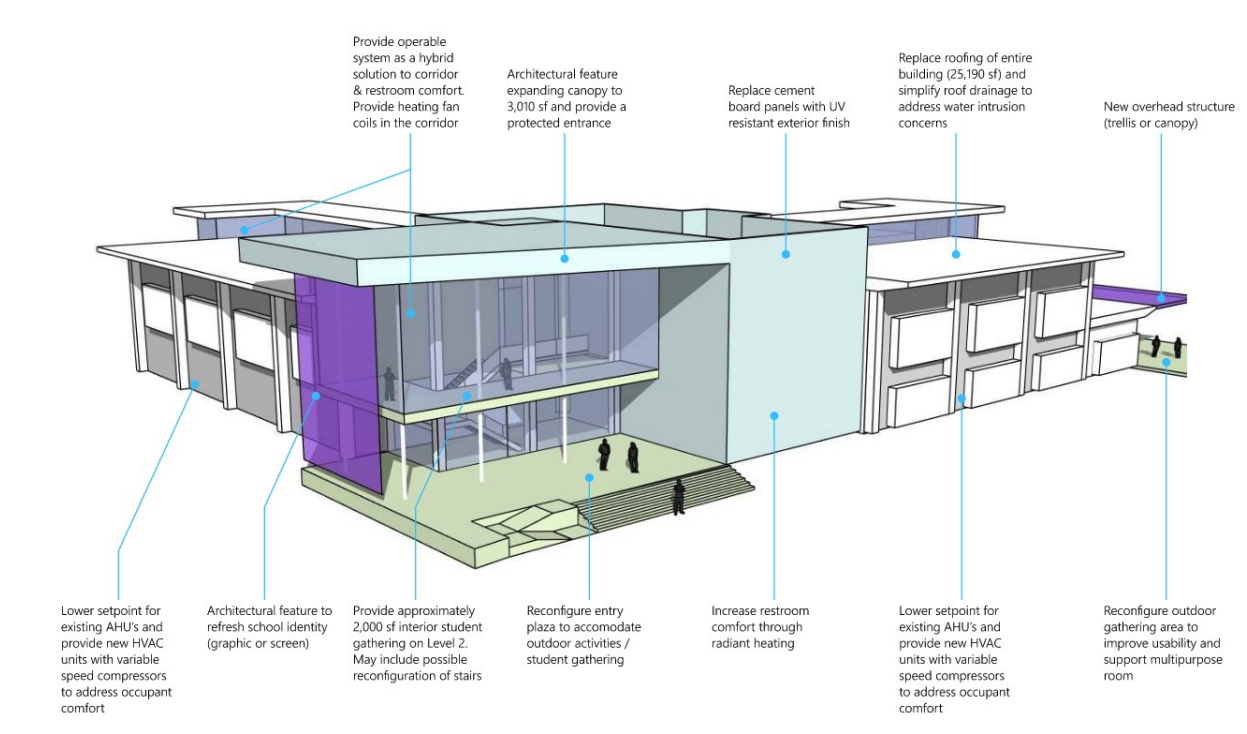

San Diego College of Continuing Education Mesa Building Envelope Improvements Concept Plan

Project Map

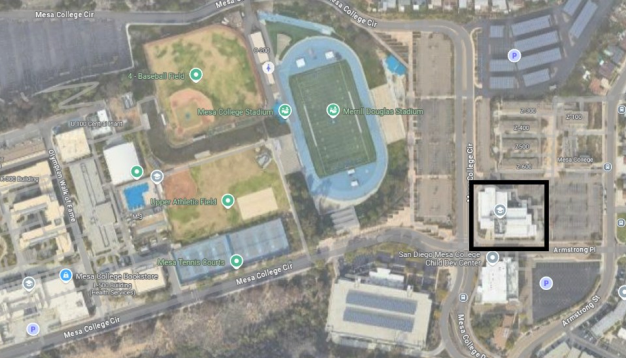

San Diego College of Continuing Education Mesa Building Envelope Improvements Map

7350 Armstrong Pl, San Diego, CA 92111

Project News & Information

Additional resources, articles, and links related to this project will appear here when available. For comprehensive information about Measure HH and all ongoing projects, please explore the Measure HH website.

Project Teams

General Contractor TBD
Architect Mosher Drew Architects
Structural Engineer Miyamoto
Civil Engineer Latitude33
Mech./ Elect. Engineer Glumac
Executive Const. Manager Steve Evanco



Last updated: June 30, 2026
