Inverter Upgrade
Project Schedule
| Programming Complete | Design and DSA Approval | Construction Completion (Est.) | FFE and Move-In (Est.) |
|---|---|---|---|
| 02-2026 | N/A | 01-29-2027 | N/A |
Current Status/Phase: Bidding Phase
Project Insights
Bid Advertisement was published on 5/18/26, with Job Walk #1 scheduled on 5/22/26 and Job Walk #2 scheduled on 5/29/26.

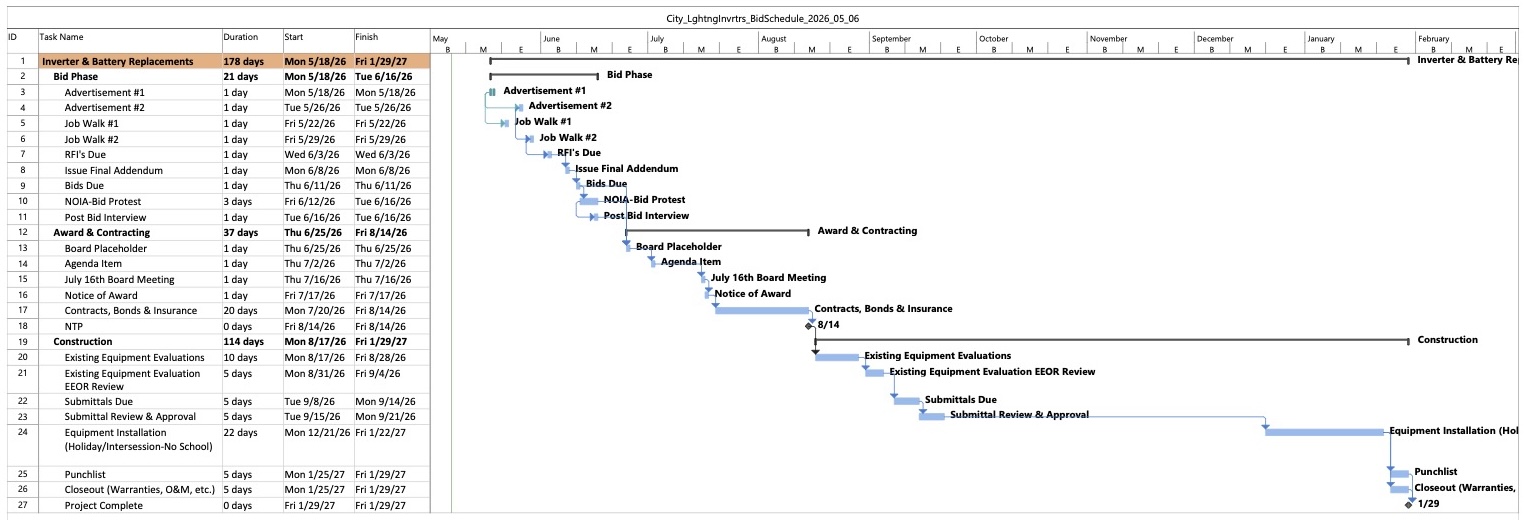

Upcoming Milestones:
- Bidding Phase: 5/18/26 - 6/16/26
- Bids Due: 6/11/26
- Board Meeting and Contract Award: 7/16/26
- Equipment Procurement and Evaluations: 8/17/26 - 9/4/26
- Equipment Installation: 12/21/26 - 1/22/27
- Punch List and Closeout: 1/25/27 - 1/29/27
Project Features

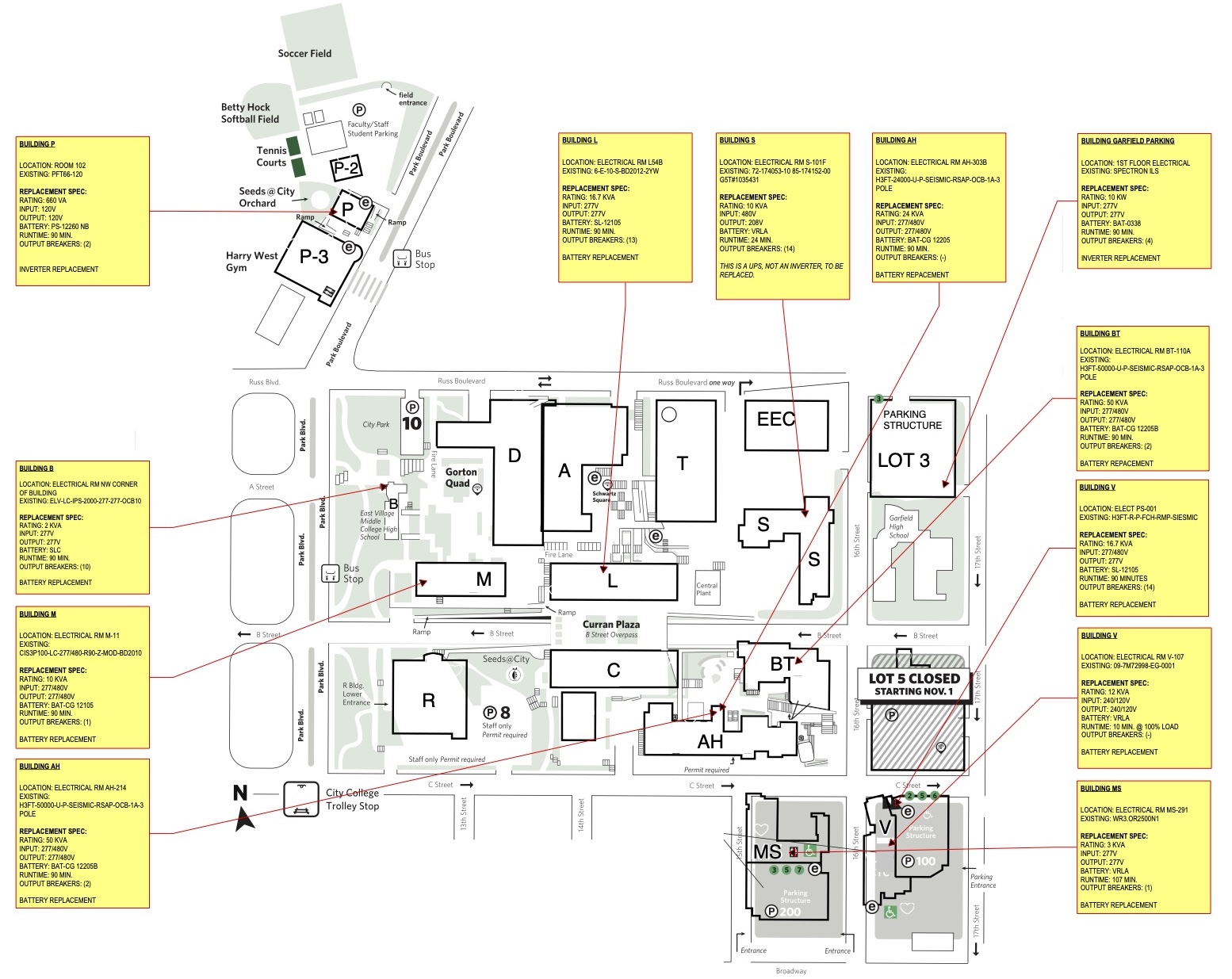

- Inverters identified in each building (Buildings P, B, M, AH, L, S, BT, V, MS and Garfield Parking Structure) are scheduled to be replaced in kind.
- Contractor shall remove existing inverters as part of their scope of work.
- Removal scope shall include associated batteries.
Project Map

1313 Park Blvd, San Diego, CA 92101
Project Schedule

Project News & Information
Additional resources, articles, and links related to this project will appear here when available. For comprehensive information about Measure HH and all ongoing projects, please explore the Measure HH website.
Project Teams
| General Contractor | TBD |
| Architect | N/A |
| Structural Engineer | N/A |
| Civil Engineer | N/A |
| Mech./ Elect. Engineer | McParlane & Associates (MPA) |
| Executive Const. Manager | Steve Evanco |
Last updated: June 1, 2026
