District Services Center South Roof

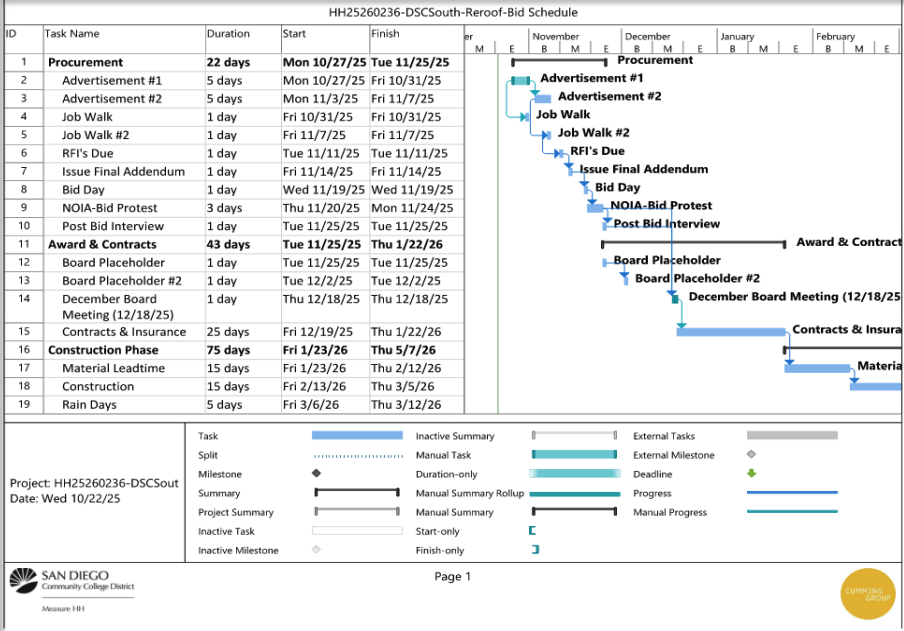

Project Schedule
| Programming Complete | Design and DSA Approval | Construction Completion (Est.) | FFE and Move-In (Est.) |
|---|---|---|---|
| August, 2025 | N/A | March 5, 2026 | N/A |
Project Progress Update

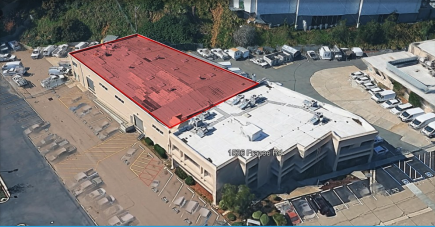

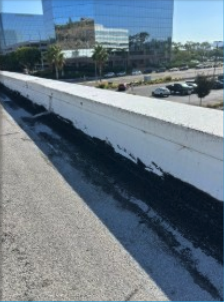

The DSC warehouse has experienced significant roof leaks for over ten years, this project aims to repair the existing DSC South roof.
Upcoming Milestones:
- Mandatory pre-job walk conferences: October 31, 2025 & November 7, 2025
- Board meeting: November 18, 2025.
- Construction Kickoff: January 21, 2025.
- Construction completion: March 5, 2026.
- Preman Roofing scheduled to begin work February 4, 2026.
Project Description
- All roof bubbles, cracks, and damaged areas will be repaired using the specified coating materials.
- Seams around rooftop units and wall panels will be reinforced with tape and coated with Cool-Sil HB White over the entire roof surface.
- Damaged duct and plenum materials will be removed; seams will then be taped and sealed using the same coating system.
- Rusted metal around exhaust fans will be treated with primer and coated with Cool-Sil HB White.
- Three new sump pumps will be installed at roof corners, including all required trade work and associated costs.
- Prior to coating, the entire roof will be pressure-washed using high-powered equipment and Simple Green.

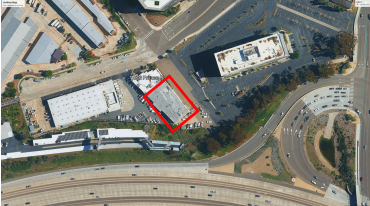

Project Map

Frazee Rd, San Diego, California 92108
Project News & Information
Additional resources, articles, and links related to this project will appear here when available. For comprehensive information about Measure HH and all ongoing projects, please explore the Measure HH website.

Project Teams
| General Contractor | Preman & Garland Roofing |
| Architect | N/A |
| Structural Engineer | N/A |
| Civil Engineer | N/A |
| Mech./ Elect. Engineer | N/A |
| Executive Const. Manager | Steve Evanco |
